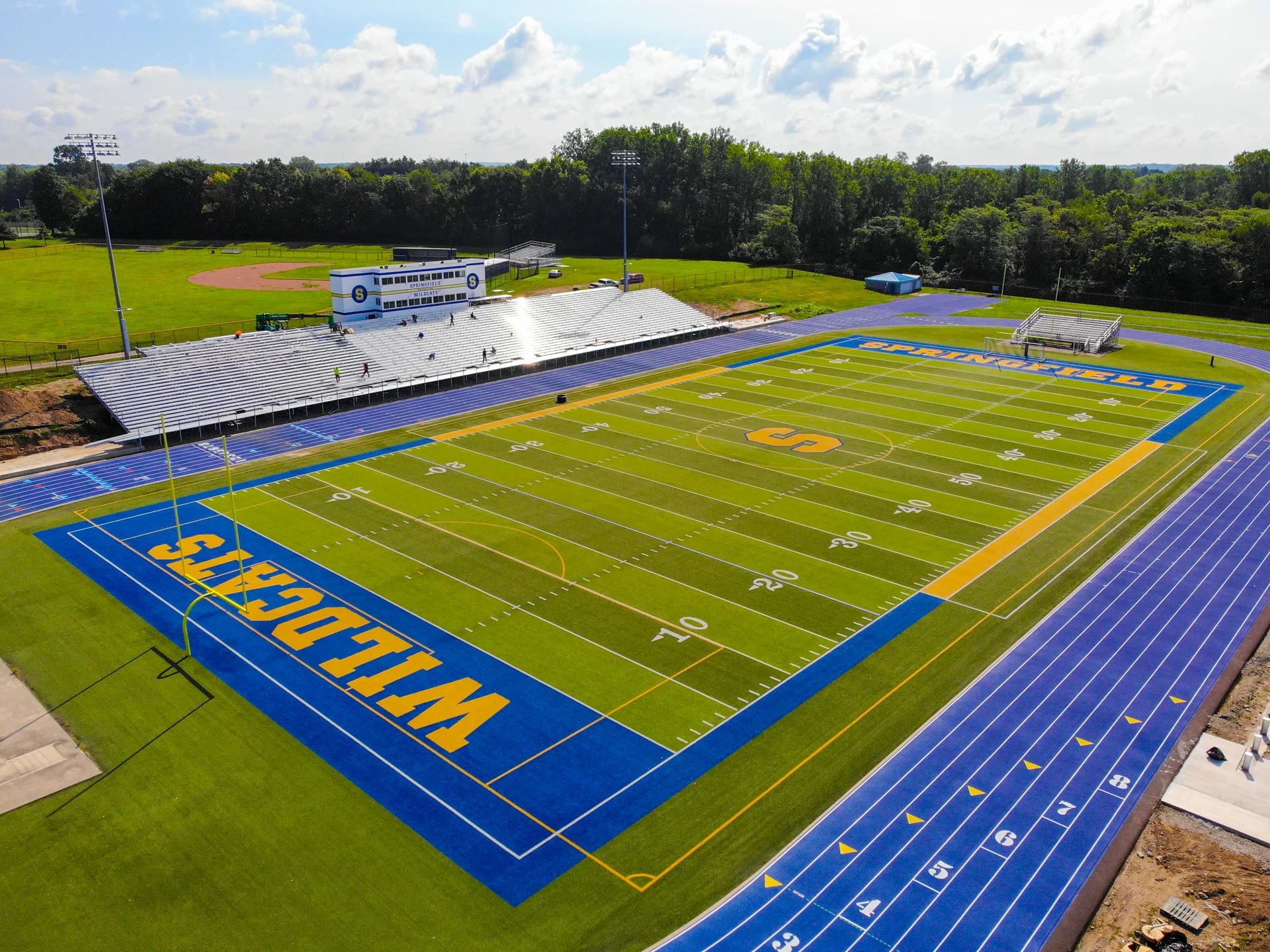

Aerial of the renovated Springfield High School stadium with turf field and blue track
Athletic FacilitiesWestern OhioDaytonTOP-C purple wordmark logo for The Ohio Purchasing Council cooperative purchasing program

Springfield High School Stadium Renovation 2026

Springfield High School's stadium was renewed in one project: new home and visitor stands seating about 6,000, a rebuilt track surfaced in dark blue rubber and marked to NFHS standards, a 30-foot-wide Samsung LED scoreboard in a new location, new drainage between the track and the stands, new paving, and new black vinyl-coated fence around the oval. Prodigy delivered it under one agreement and worked out the seating arrangement with the City of Springfield. The district bought it pre-bid on a council of governments unit price contract.

The stadium at Springfield High School, in Springfield, Ohio, had reached the point where its major pieces were aging together. Both bleacher systems, the track surface, the scoreboard and the asphalt between them were all at the end of their service lives at roughly the same time, which is the situation that turns a stadium into a series of annual patches unless a district decides to do the whole thing at once. Springfield decided to do the whole thing at once.

The renovation replaces both sets of stands with new systems of approximately 4,000 seats on the home side and 2,000 on the visitor side, rows 26 inches deep, skirt boards facing the field in a dark blue the owner picks, and the home structure tied into the existing press box. The seating arrangement was worked out with the City of Springfield to eliminate the need for a paved path across the front of the stands. The scoreboard moves: the old posts and utilities are cut below grade and the turf patched, and a new Samsung LED board, sixteen feet five inches tall by thirty feet wide, goes up in the new location with an ad cabinet below, an arched truss above, two thirty-inch play clocks, a console and content management software.

The track is taken down to base stone and rebuilt — new asphalt, then a Conica Conipur SP rubber system in dark blue over the oval, the high jump area and the long jump and pole vault runways, marked to NFHS standards. Underneath all of it, a new drainage system runs between the track and the stands, the surrounding asphalt is milled and overlaid, and the fence around the oval is replaced with five-foot black vinyl-dipped fence and three gates. The work is under an owner-contractor agreement executed in October 2025, bought pre-bid on a council of governments unit price contract, with substantial completion set for August 2026.

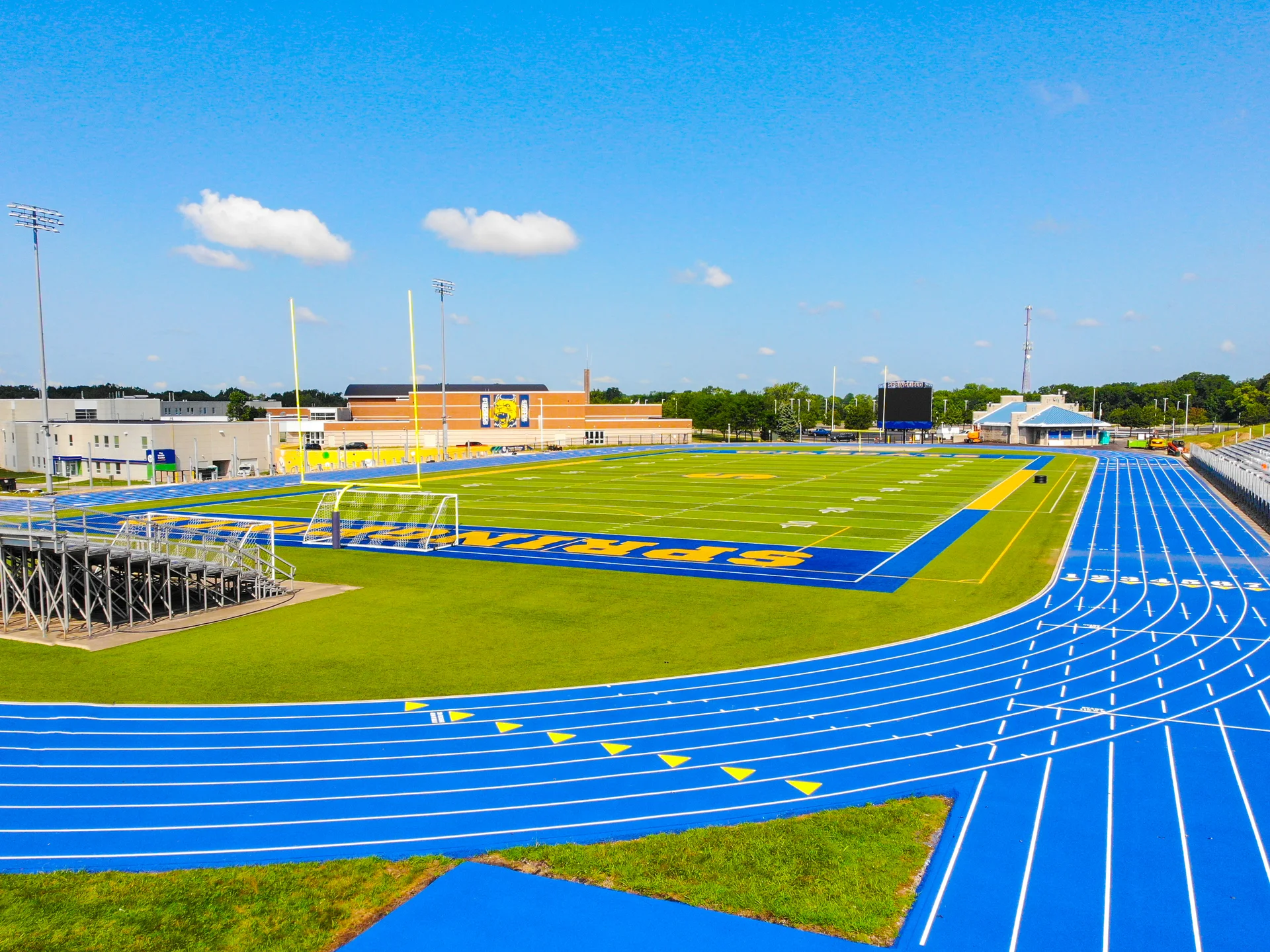

Springfield turf field and grandstand seen from the new track surface

Numbered lanes on the Springfield track below the stadium video board

Curve of the new blue track around the Springfield turf infield

Straightaway of the resurfaced Springfield track with new stadium light poles

Boom lift working at the new video scoreboard beyond the Springfield track

Springfield track curve with the video board and field house beyond

Technical Discussion

Prodigy as the design professional of record

There is no separate architect or engineer on this project. Prodigy is the design professional of record and also the contractor, which removes the handoff most stadium projects are organized around — the point where drawings leave one firm and become another's problem to price, then return to the first the moment the field disagrees with them.

What that changes shows up where the contract expects the field to disagree. Before the new track asphalt is placed, existing gravel depth has to be verified as exceeding five inches. That is a real test with a real branch: if the stone is thin, the section changes. Under a split arrangement that becomes an RFI, a revised detail and a change order negotiated between two parties with opposite incentives. Here the party that wrote the section is the party standing on the stone.

The same is true of the demolition. The home bleachers come out with their foundations; the visitor bleachers come out with their foundations left in place. That is a design decision about existing conditions, made in front of the excavation rather than in an office months earlier. So is the seating layout, coordinated with the City of Springfield Planning and Development Department and arranged so no paved path is needed across the front of the stands. A separate designer would have drawn that path and a contractor would have priced it; one party carrying both eliminated it.

The check the district keeps is written into the same contract. Shop drawings go to the owner for approval before anything is fabricated, the city reviews the bleacher design, and the scope states its own boundaries — no undercutting and no asphalt base repairs are included. Single-source responsibility is worth having because someone can be held to lines that were drawn.

Fitting bleachers, track and scoreboard into one off-season

Work starts November 1, 2025 and substantial completion is set on or before August 1, 2026. Inside that window sit four scopes wanting the same ground, and their order is not a preference. It is set by what cures, what has to be surveyed, and what needs heavy equipment driven across the field.

The bleachers start first and finish late, because their long pole is approval rather than erection: the design is finalized with the city, shop drawings go to the owner, and only then is anything fabricated. Demolition runs in parallel — the existing systems come out and the asphalt between the track and the stands is removed on both sides. That opens the ground for the drainage system between the track and the new stands, which has to go in before anything is paved over the top of it.

The scoreboard belongs in the middle, not at the end. Cutting the old posts and utilities to no less than three inches below grade, backfilling, patching turf, then setting new posts and utilities in the new location is trenching and lifting work across ground nobody wants to cross once a finished surface is down.

The track is last for the same reason, and it has a fixed internal order of its own. The rubber and asphalt on the oval and high jump area are milled to base stone. Gravel depth is verified, the area fine graded and compacted, then two inches of ODOT base asphalt and an inch and a half of surface course in virgin mix go down. Only after that asphalt has cured can the Conica Conipur SP system go over it — a half-inch basemat and a dark blue structural spray. The long jump and pole vault runways keep their concrete; their old rubber is stripped and the surfaces cleaned so they take the same system on the same pass.

The lane lines come last of all, and that is the point worth making to anyone who has watched a track project run late. Markings are laid out to NFHS standards off the finished oval, surveyed on the surface that exists rather than the one that was demolished. Every hour of drainage, paving and scoreboard work that slips pushes against the one operation that cannot be started early and cannot be rushed.
