Beavercreek City Schools HVAC Installation 2026

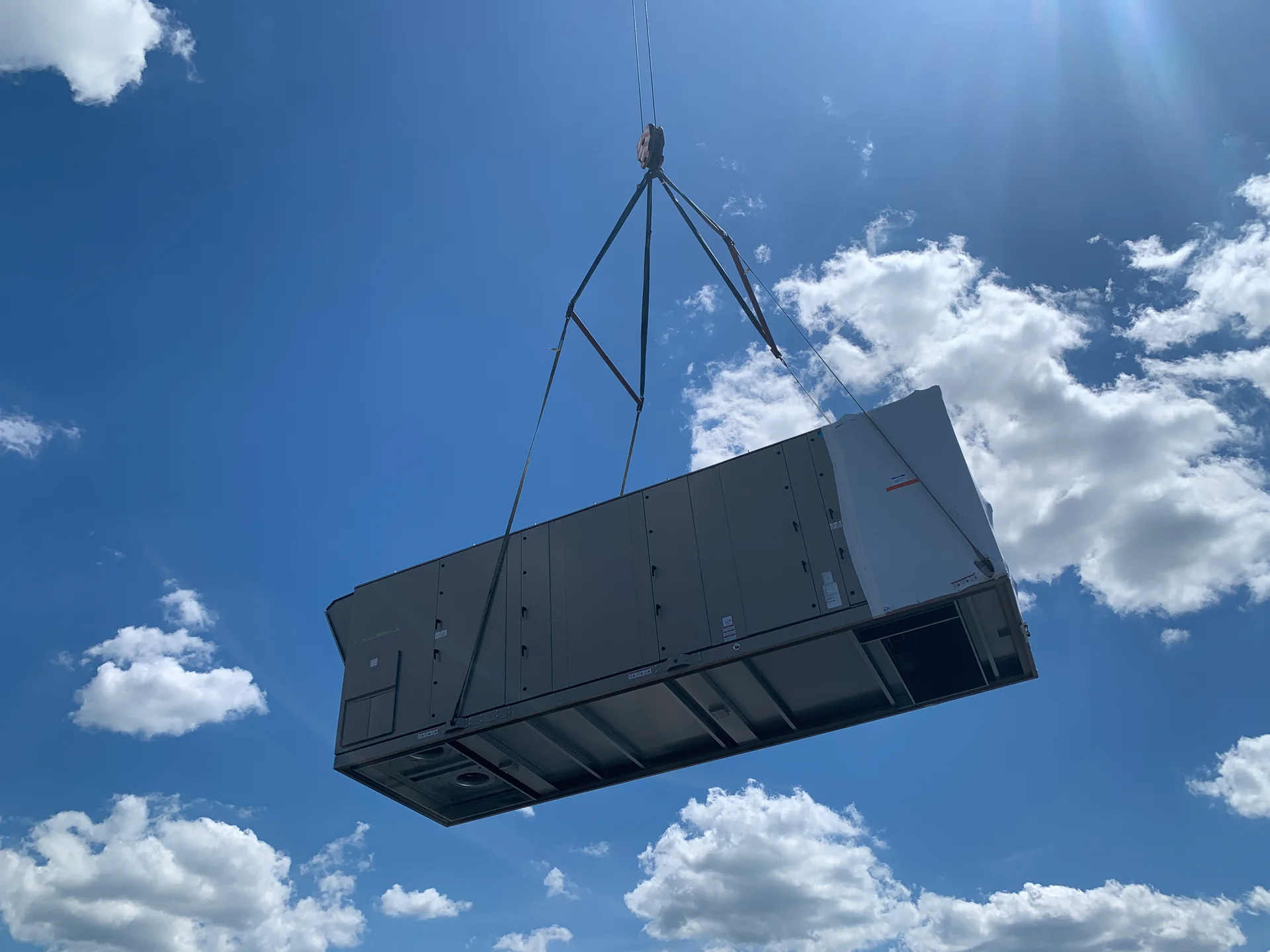

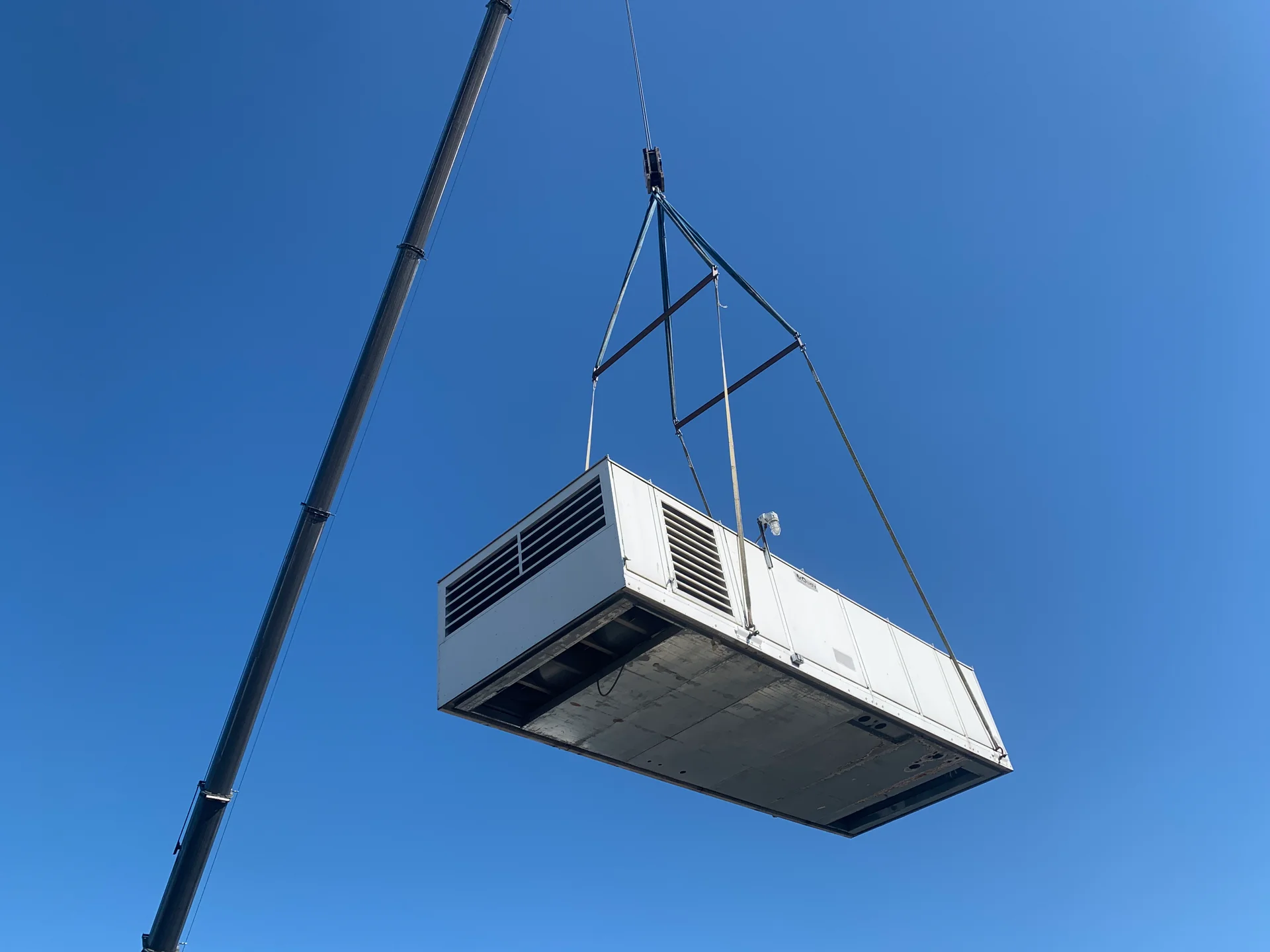

Six new Daikin rooftop air handlers now serve Beavercreek High School, installed in a single summer as Phase 1 of a phased replacement while the rest of the building's units stayed in service. Prodigy set the units, four of them on new curb adapters over the existing roof openings, and completed the ductwork transitions, hot and chilled water piping, electrical and temperature controls for each. Every unit matches the capacity of the one it replaced and comes with an enthalpy economizer and two-stage MERV 8 and MERV 14 filtration. The district purchased the work directly, with bonds and permits included.
Beavercreek City Schools is replacing the rooftop air-handling units at Beavercreek High School in phases rather than shutting the whole system down in one summer. Phase 1 covers six of them — AH-1, AH-2, AH-3, AH-5, AH-6 and AH-10 — together with the transition ductwork, hot and chilled water piping, electrical service and temperature controls that go with each one. The units not in this phase stay in service and wait their turn.

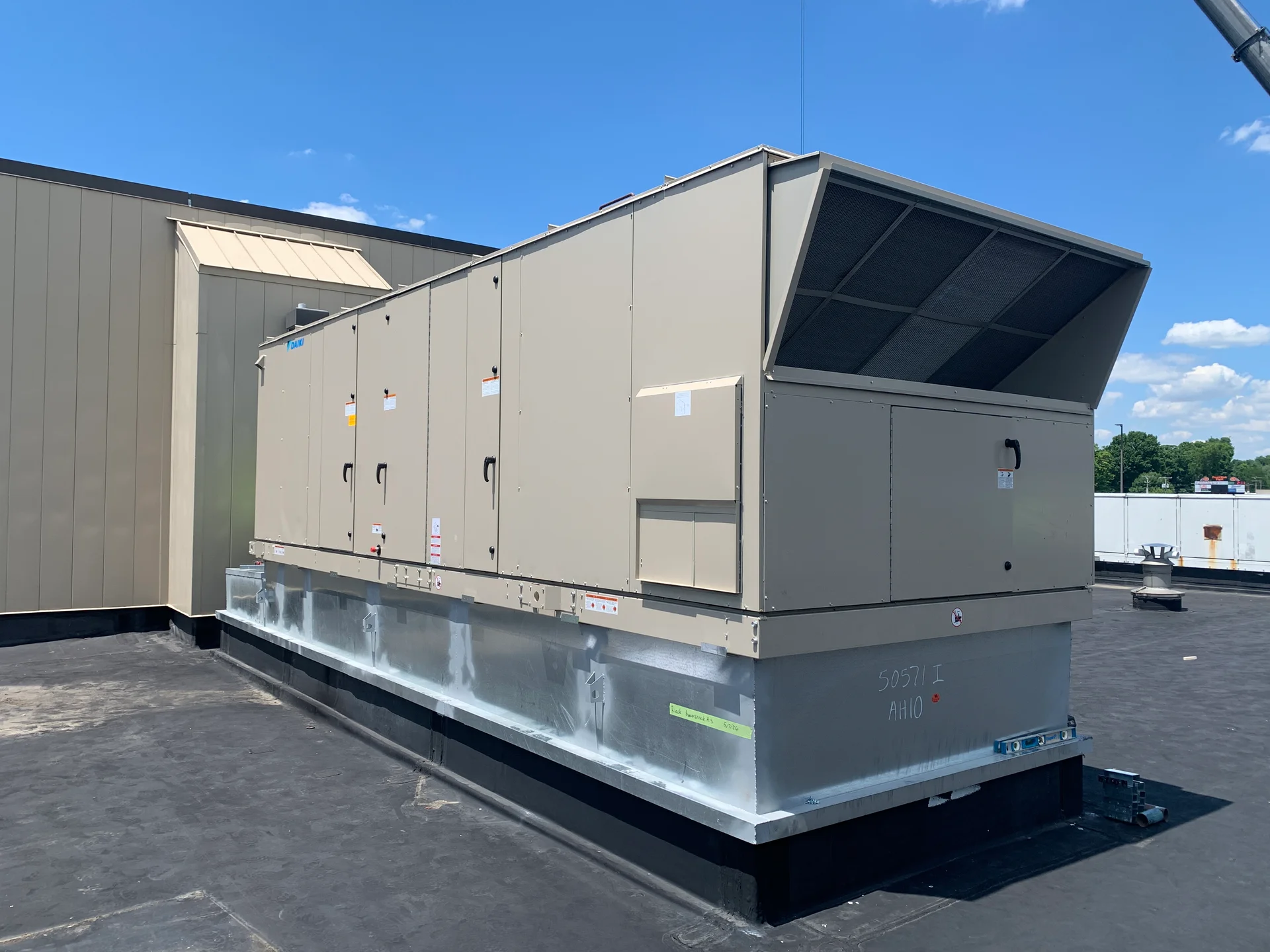

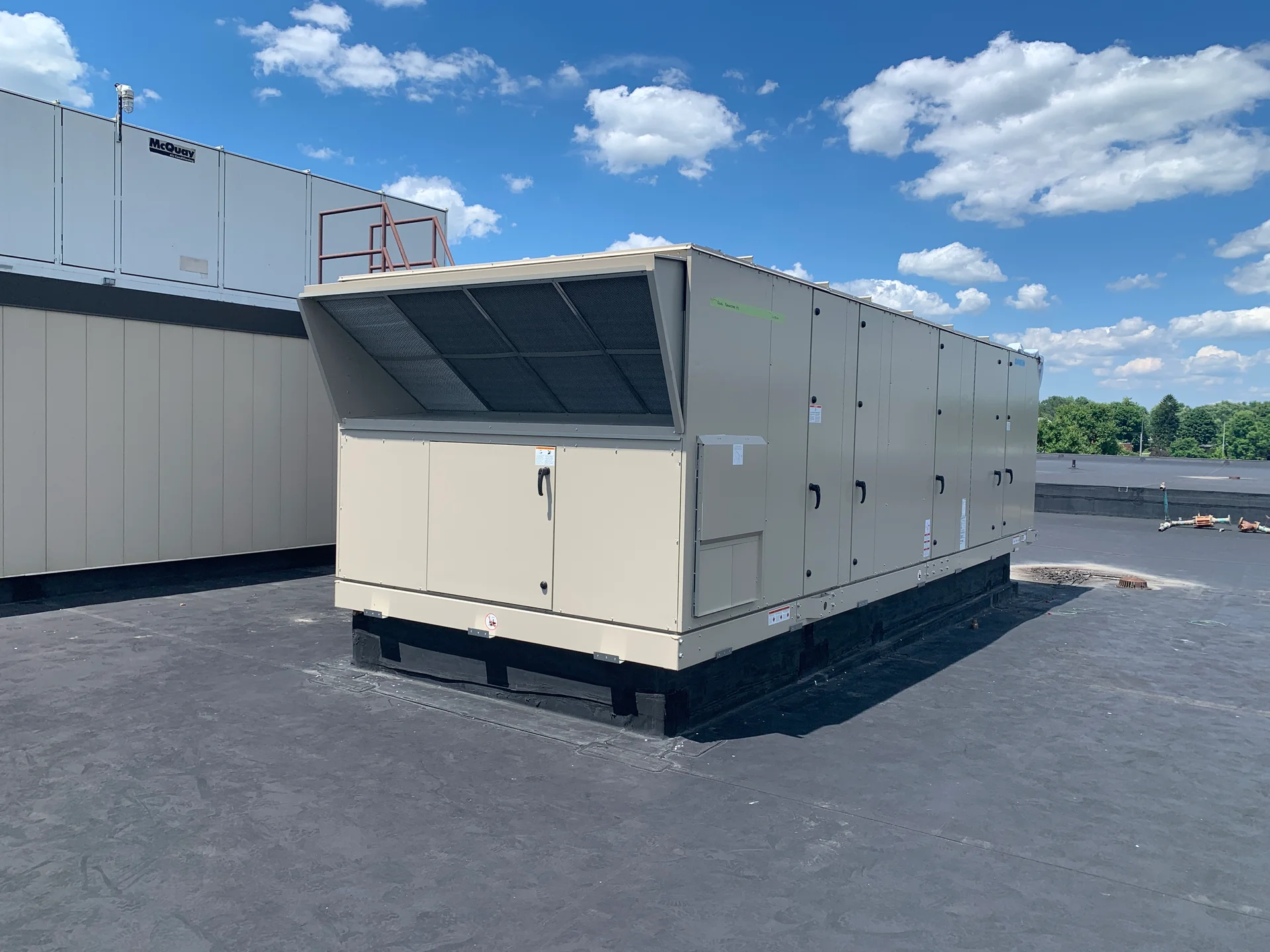

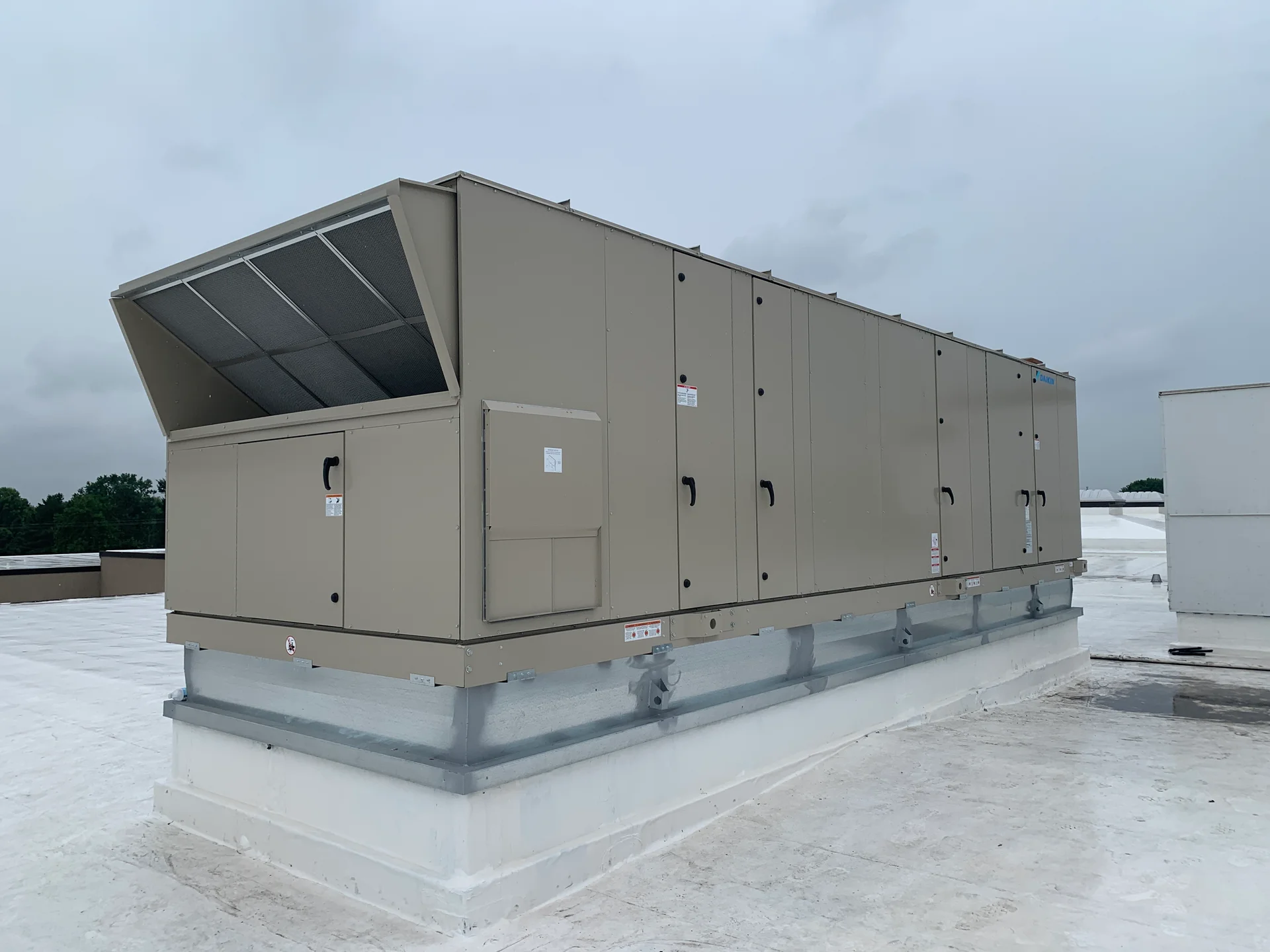

The district wrote the sizing into its own bid documents. Every new unit was matched to the heating, cooling and airflow capacity of the one it replaces, and no load or ventilation calculations were part of the work. The six Daikin units are double-wall, foam-injected cabinets with ECM fan arrays, mixing boxes, enthalpy economizers, hot water and chilled water coils, and two stages of filtration — 2-inch MERV 8 ahead of 4-inch MERV 14. Four of the six set on new curb adapters over the existing roof openings; AH-10 also picks up a duct-mounted hot water reheat coil sized for a 20-degree air temperature rise.
The district bought the work direct, on an equipment and services purchase agreement with its Board of Education, with scope and materials drawn from bid documents the district had already issued. Payment and performance bonds and permits are carried in the agreement, which sets substantial completion on or before August 1, 2026 — one summer, six units, a building that opens on time either way. What the district gets out of Phase 1 is equipment it can still service and a control system that finally reports what the equipment is doing.
