Fairfield Senior High School has eight rebuilt tennis courts: new asphalt over a crack-bridging membrane, a six-coat acrylic surface in two colors, new net posts set in new concrete, and ten-foot black vinyl-coated fence with three gates. Prodigy fixed the cause before the surface, installing underdrains between the courts and a 360-foot swale that keeps runoff off the pavement, and carried the design and permitting for Fairfield City School District. The district bought the project pre-bid through the TOP-C cooperative contract.
Fairfield City School District had eight tennis courts at Fairfield Senior High School with a water problem before it had a surface problem. Runoff entered the courts from the south and east, the asphalt had cracked along roughly 1,100 linear feet, and cracks like that come back through a color coat within a season. Paint was never going to be the answer, and a full reconstruction would have been priced against pavement that was still sound.

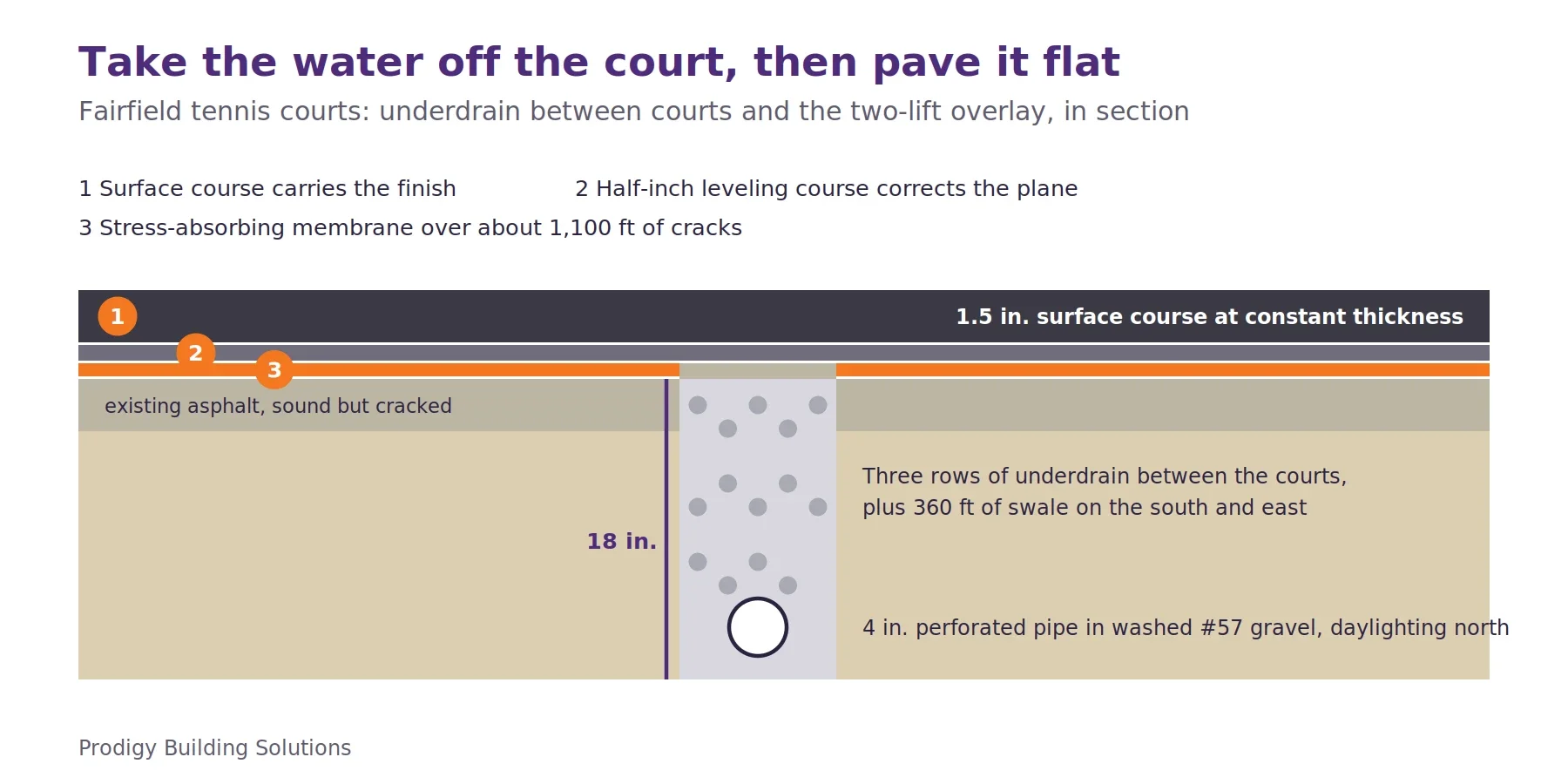

So the drainage was dealt with first and the playing surface second. Three rows of underdrain went in between the courts, ground eighteen inches down and built back up with geotextile fabric, washed #57 gravel and four-inch perforated pipe daylighting to the north. A 360-foot swale was cut along the uphill sides to intercept surface water before it ever reached the pavement. Only then did the courts get their cracks bridged with a stress-absorbing membrane interlayer, a half-inch leveling course and an inch-and-a-half ODOT Type 1 surface overlay.
What the district gets back is eight courts inside new ten-foot black vinyl-dipped fence with three gates, finished in a six-coat acrylic system — rust inhibitor over the new pavement, two coats of resurfacer, three coats of color in two colors, and white tennis lines. An amendment during the job added new below-grade net structures, so the posts sit in new concrete and new sleeves rather than the old footings, with new nets and center tie-downs. The work was bought pre-bid on a TOP-C unit price contract, with substantial completion set for mid-August 2026 and the district's own design and permitting carried by Prodigy.
