Two elementary schools and the district's Transportation Office in Milford came back from summer break with smooth, freshly striped asphalt and water that now goes where it should. For the Milford Exempted Village School District, Prodigy Building Solutions planned and delivered one paving and drainage package across three sites: Mulberry Elementary, McCormick Elementary and the Transportation Office. The work covered asphalt milling and resurfacing, full-depth base repairs, new trench drains with outlet piping, a perforated underdrain, rebuilt concrete catch basin collars, hot-applied crack sealing, and new striping, crosswalks and car stops. It was procured through the district's TOP-C cooperative contract.

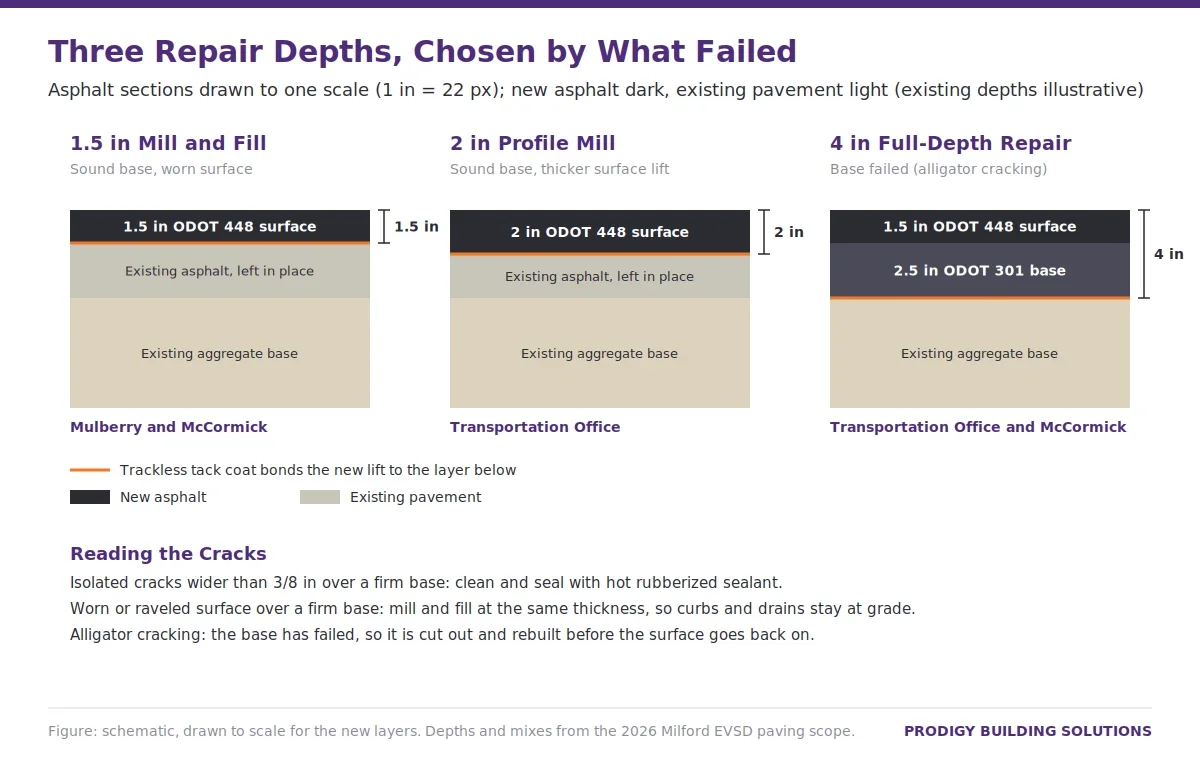

Each lot got the treatment its pavement called for rather than one blanket overlay. Where the asphalt base was still sound, the worn top was milled off and replaced with a new surface course. Where the base had failed, crews cut deeper and rebuilt it before paving. Where the pavement was still in good shape, the cracks were cleaned and sealed to keep water out and buy years before the next resurfacing. That approach puts the district's money into the areas that needed it most.

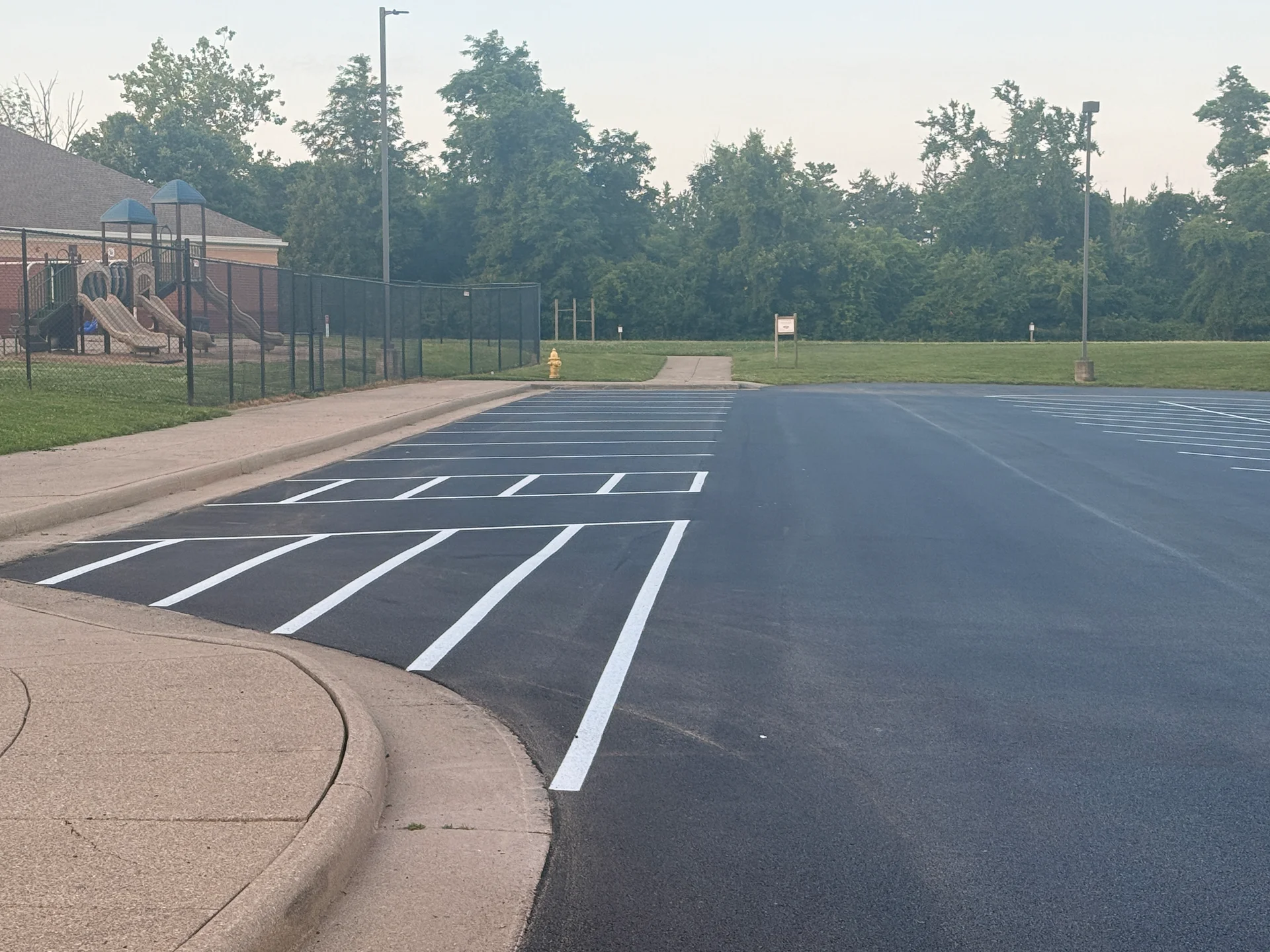

Drainage was part of the plan from the start. At Mulberry, a road-grade trench drain set in fiber-reinforced concrete now catches water across the pavement and carries it to daylight. At McCormick, a second trench drain ties into an existing catch basin, and a perforated underdrain bedded in washed stone pulls groundwater out from under a section of pavement before it can soften the base. Catch basin collars at both schools were cut out and rebuilt in fiber-reinforced concrete, which gives the asphalt around each basin a solid edge to meet.

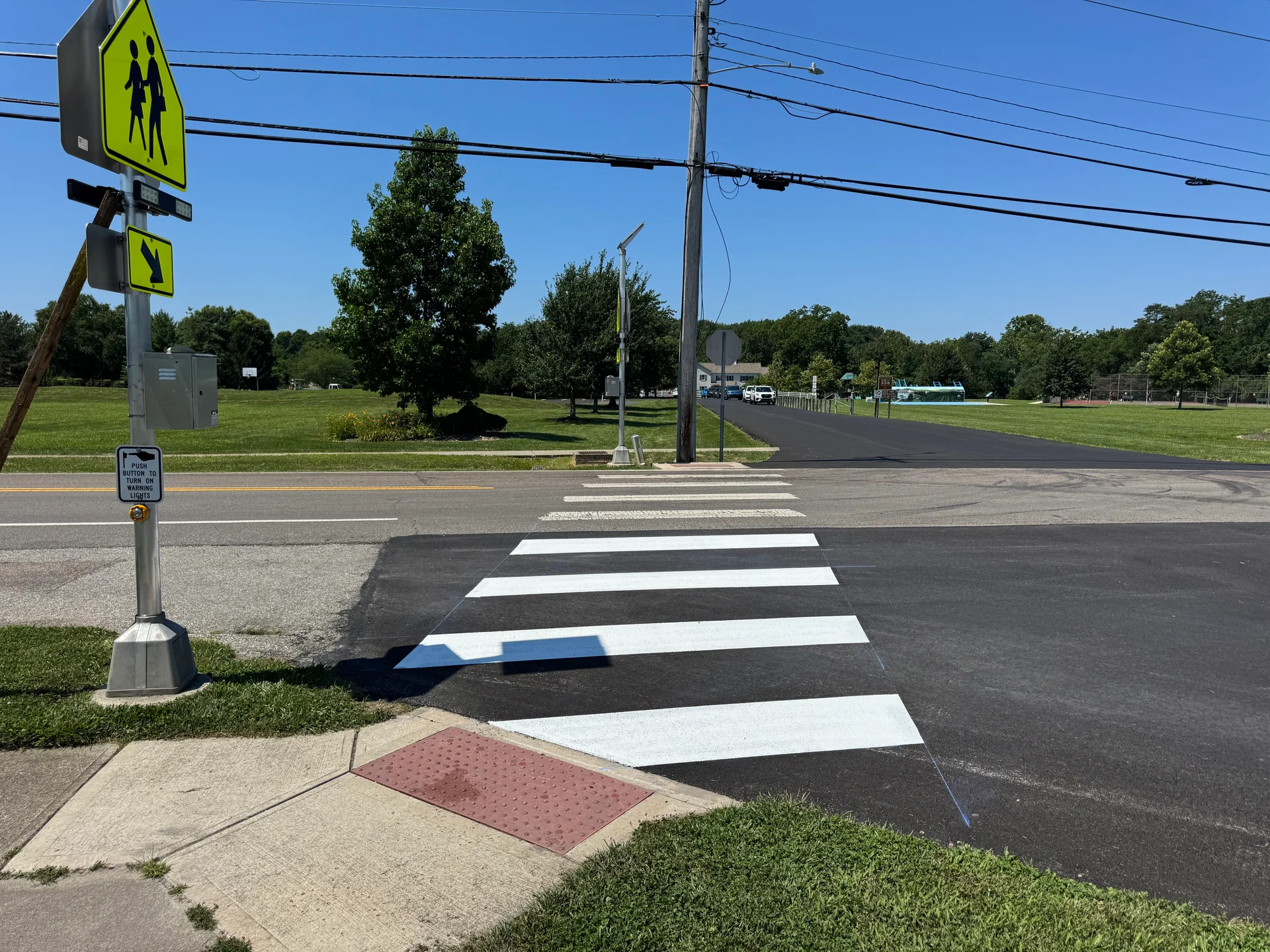

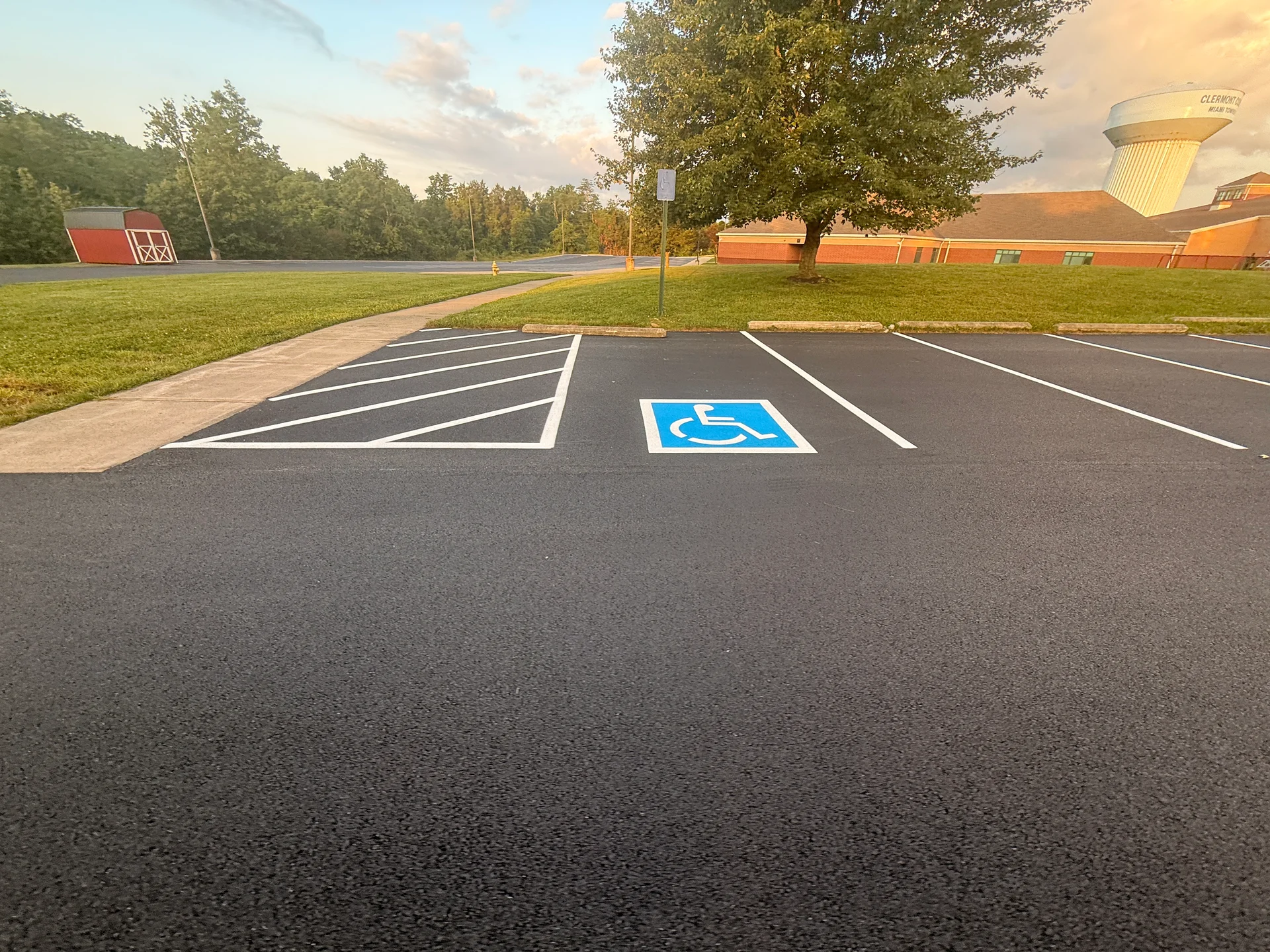

The stripes were laid back out to match each lot's existing traffic pattern, with crosswalks, accessible spaces and the hatched islands around light poles repainted, and the car stops at the Transportation Office were pulled, stockpiled and reset on the new surface.
The schedule was set by the school calendar. The paving and drainage work was finished in the summer break so buses, parents and staff returned to finished lots.
Milford now has three sites with new pavement where it was needed, drainage that carries water away from it, and sealed cracks protecting the pavement that still had years left.
