•••
Patrick Henry High School entrance lobby with the school logo inlaid in the mat
Building RenovationNorthwest OhioDaytonTIPS

Patrick Henry Building Renovation 2020

Patrick Henry High School was renovated from the pipes under the slab to the roof in one design-build project: air conditioning for a building that had none, new underground storm and sanitary piping, rebuilt restrooms, five new roof sections under a 30-year warranty, new floors, ceilings, lighting, lockers, casework and furniture, a new gym floor with about 1,177 seats of motorized bleachers, and new LED stadium lighting. Work started in March 2020 and the building was ready for classes that September. Patrick Henry Schools bought it under one agreement, pre-bid through TIPS.

Patrick Henry Schools had a high school where the systems had aged into one another. The underground storm and sanitary piping was judged too fragile to patch and had to come out from under the slab. The building was not air conditioned, there was no fire sprinkler system, and the return air path ran through louvers in the classroom doors to the corridor and up to the units — a route that no longer met code. Five of the eight roof sections were coming off, one of them a ballasted membrane dating to 1981. Fixing any one of those meant opening the floor, the ceiling or the roof that the others also needed opened, so the district bought them together, as a single design-build agreement pre-bid through TIPS contract 181101.

The building was converted to chilled-water cooling: one 180-nominal-ton air-cooled chiller with a dual-pump package feeding five tri-deck multizone rooftop units sized to the existing curbs, with the chilled water charged to 30 percent glycol for the run across the roof. New PVC storm piping in 4-inch through 12-inch sizes was tied back to 18 existing risers, with new sanitary below the slab and the restrooms rebuilt to current code. Five roof sections were rebuilt to an average R-25 under fully adhered 75-mil EPDM carrying a 30-year warranty. Inside, the district got LVT in classrooms, epoxy in the corridors, quarry tile in the kitchen, a new gym floor, roughly 1,177 seats of motorized telescopic bleachers, 464 LED flat panels with occupancy sensors and 41 dimmer zones, new ceilings, doors, lockers, casework and classroom furniture. At the stadium, six old poles came out and four new LED poles went in near the 20-yard lines, designed for an average of 50 horizontal foot-candles on the field.

Work started in March 2020, the building was ready for classes on September 1 that year under a temporary certificate of occupancy, and the corridor epoxy was finished over the winter break on January 4, 2021. Amendment No. 1, signed that same January, is part of this project: it removed the gymnasium video system and the gym and stadium sound systems, changed the gym floor to a build-up over the existing sleepers instead of a full tear-out, and redirected the difference into what demolition had exposed.

Extended gym bleachers lettered P H below the Patrick Henry scoreboard
Patrick Henry auditorium stage with acoustic shell and choral risers
Patrick Henry cafeteria with folding tables and Patriots wall graphics
Locker-lined corridor with new lighting and blue soffit at Patrick Henry
Classroom with mobile tables and red chairs at Patrick Henry High School
Trophy cases lining a renovated corridor at Patrick Henry High School
Patrick Henry gymnasium with new lighting, banners and red bleachers
Renovated Patrick Henry restroom with blue partitions and a trough sink
Patrick Henry classroom arranged in a U with new casework along the wall
Locker bay with new lockers and benches at Patrick Henry High School
Patrick Henry restroom fixtures and privacy screens after renovation

Technical Discussion

A tri-deck multizone on the existing curbs

Patrick Henry had rooftop multizone units serving 54 zones and no air conditioning. The textbook way to add cooling to a building like that is to convert it to variable air volume: new air handlers, a VAV box in the ceiling above every zone, and new ductwork to connect them. It works, and it means rebuilding the distribution in every room of a building that was also getting new plumbing, sprinklers, ceilings and floors. The project kept the multizone layout instead and changed the kind of multizone.

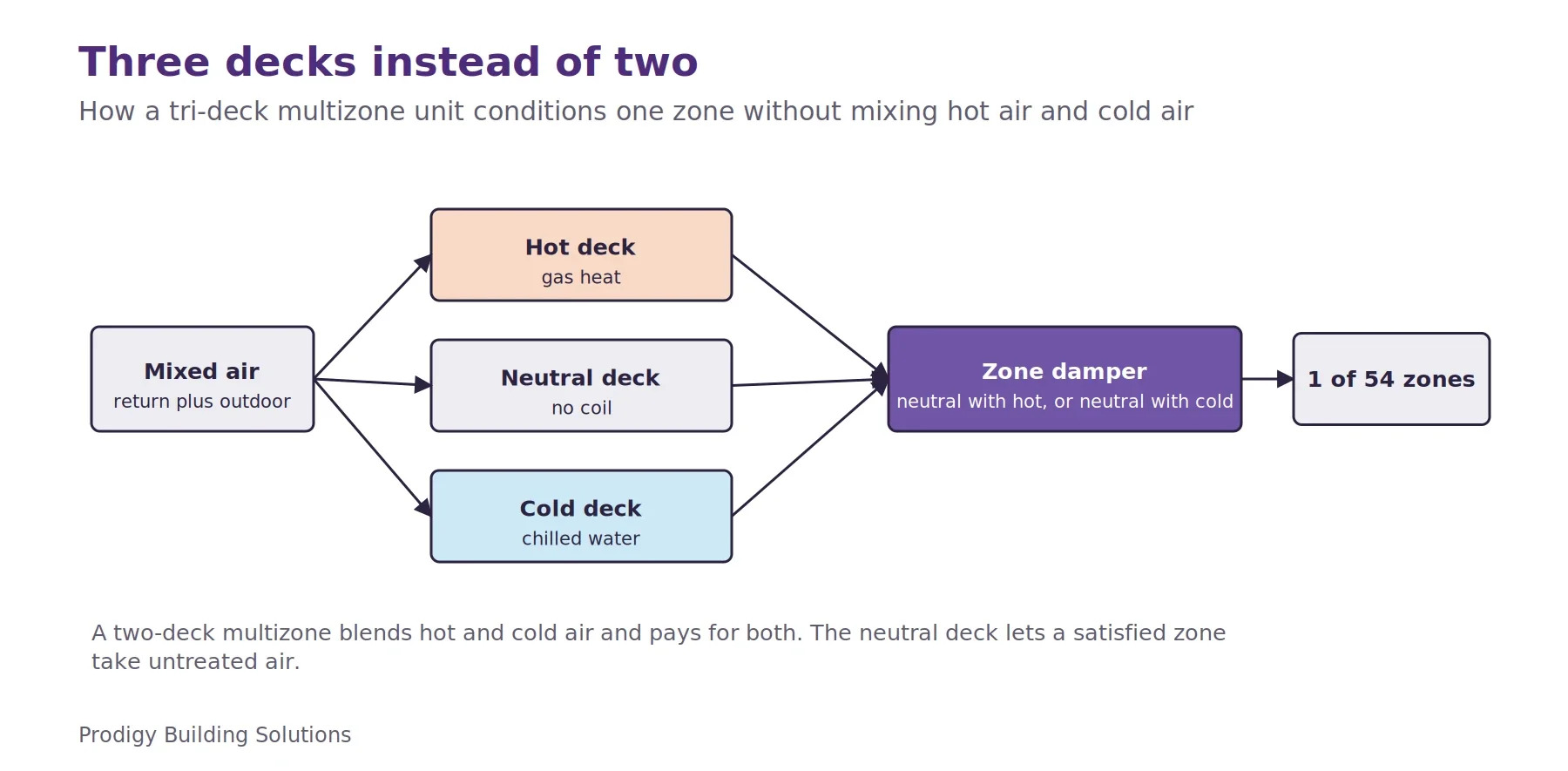

Flow diagram of a tri-deck multizone air handler. Mixed air splits into a gas-fired hot deck, a neutral deck with no coil and a chilled water cold deck. A zone damper blends neutral air with either hot or cold air, never hot with cold, and supplies one of 54 zones.
Figure 1 — The neutral deck is what stops a multizone unit from heating and cooling the same air.

What was wrong with the old multizone

A conventional multizone unit has two decks, one hot and one cold, with a pair of dampers per zone that blend the two streams. It gives every zone its own temperature from one unit, and it does it by heating and cooling air at the same time and mixing them. Any zone that wants a mild temperature is burning gas and running a chiller to get it. Energy codes have restricted that arrangement for decades.

The third deck

A tri-deck unit adds a neutral deck that carries mixed air past both coils untouched. Each zone damper blends neutral air with cold air, or neutral air with hot air, and never hot with cold. A zone that needs nothing gets neutral air, and no energy is spent on it. The five new units are tri-deck machines with a chilled water cold deck, a gas-fired hot deck and the neutral deck between them, with direct-drive fans on ECM motors and MERV 8 filtration, and they were built to fit the existing roof curbs. Each of the 54 zones kept its own duct and gained a modulating damper and a new wall thermostat on direct digital control.

Where the cooling comes from

One 180-ton air-cooled chiller with a variable primary pump package feeds all five cold decks through piping run across the roof. Because that piping is outdoors, the loop is charged with 30 percent glycol. The chiller runs a 40 to 50 degree leaving water range, and variable speed drives on the compressors and pumps let it follow the load down through spring and fall.

Four numbers that stop a roofing crew

Five roof sections were torn off and replaced with fully adhered 75-mil EPDM over tapered insulation averaging R-25. Fully adhered means the membrane is glued to the board below it, and adhesive is sensitive to weather in ways a mechanically fastened sheet is not. The agreement defined a weather day in advance with four thresholds: a rain forecast above 35 percent, air temperature under 48 degrees, wind over 12 miles an hour, or less than 7 degrees between the air temperature and the dew point.

Each number guards against a specific failure. Rain matters most on a tear-off, because an open deck has nothing over the classrooms below. Bonding adhesive has to flash off its solvent before the sheet is mated, and below the high 40s it does so slowly and unevenly. Wind lifts a wide sheet while it is being positioned and blows dust onto wet adhesive. The dew point spread is the subtle one: when the roof surface is within a few degrees of the dew point, moisture condenses on the adhesive film as it cools, and the membrane is bonded to water instead of insulation. That roof looks perfect the day it is finished and blisters the next summer.

Writing the thresholds into the agreement took the judgment call away from a superintendent with a deadline. Days lost to those four conditions were added to the end of the schedule, so nobody had a reason to glue a roof on a morning it should not have been glued.
